on Wednesday, July 19th 2023, 6:30:00 pm
Work Sanctioned
राज्य योजना के अन्तर्गत जनपद ऊधमसिंह नगर के विधानसभा क्षेत्र रूद्रपुर में आवास विकास पुलिस चैकी से अटरिया मार्ग तक मार्ग का सीमेन्ट कंक्रीट ब्लाॅक पेवमेन्ट द्वारा निर्माण कार्य। (विस्तृत आगणन)
on Wednesday, May 1st 2024, 6:30:00 pm
20%
Physical Progress
Physical Progress Reported at 1st time
on Thursday, May 30th 2024, 6:30:00 pm
33.81%
Financial Progress
1st Expenditure
of ₹ 5475822 (54.76 Lacs ) done.
Cummulative ₹ 54.76Lacs ( against 161.98Lacs )
on Wednesday, June 19th 2024, 6:30:00 pm
35.22%
Financial Progress
2nd Expenditure
of ₹ 228684 (2.29 Lacs ) done.
Cummulative ₹ 57.05Lacs ( against 161.98Lacs )
on Thursday, June 27th 2024, 6:30:00 pm
35.79%
Financial Progress
3rd Expenditure
of ₹ 92697 (0.93 Lacs ) done.
Cummulative ₹ 57.97Lacs ( against 161.98Lacs )
on Thursday, June 27th 2024, 6:30:00 pm
35.89%
Financial Progress
4th Expenditure
of ₹ 15900 (0.16 Lacs ) done.
Cummulative ₹ 58.13Lacs ( against 161.98Lacs )
on Thursday, July 25th 2024, 6:30:00 pm
36.40%
Financial Progress
5th Expenditure
of ₹ 82448 (0.82 Lacs ) done.
Cummulative ₹ 58.96Lacs ( against 161.98Lacs )
on Sunday, August 11th 2024, 6:30:00 pm
36.75%
Financial Progress
6th Expenditure
of ₹ 58015 (0.58 Lacs ) done.
Cummulative ₹ 59.54Lacs ( against 161.98Lacs )
on Tuesday, September 3rd 2024

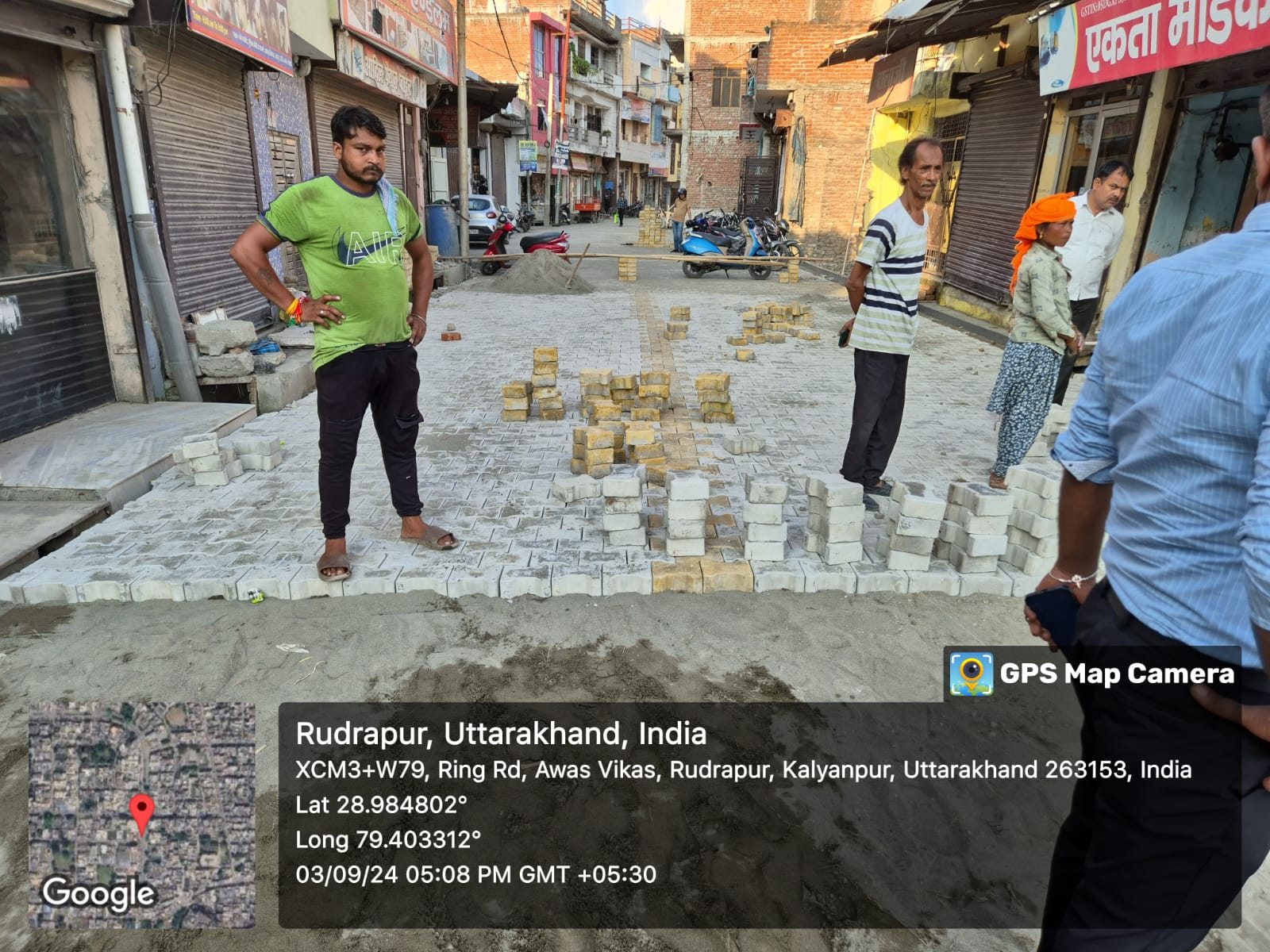

PWD UttarakahndPhoto (ID 1094) from Site Received
null
on Thursday, September 26th 2024, 6:30:00 pm
38.28%
Financial Progress
7th Expenditure
of ₹ 246628 (2.47 Lacs ) done.
Cummulative ₹ 62.00Lacs ( against 161.98Lacs )
on Saturday, September 28th 2024
PWD UttarakahndPhoto (ID 1158) from Site Received

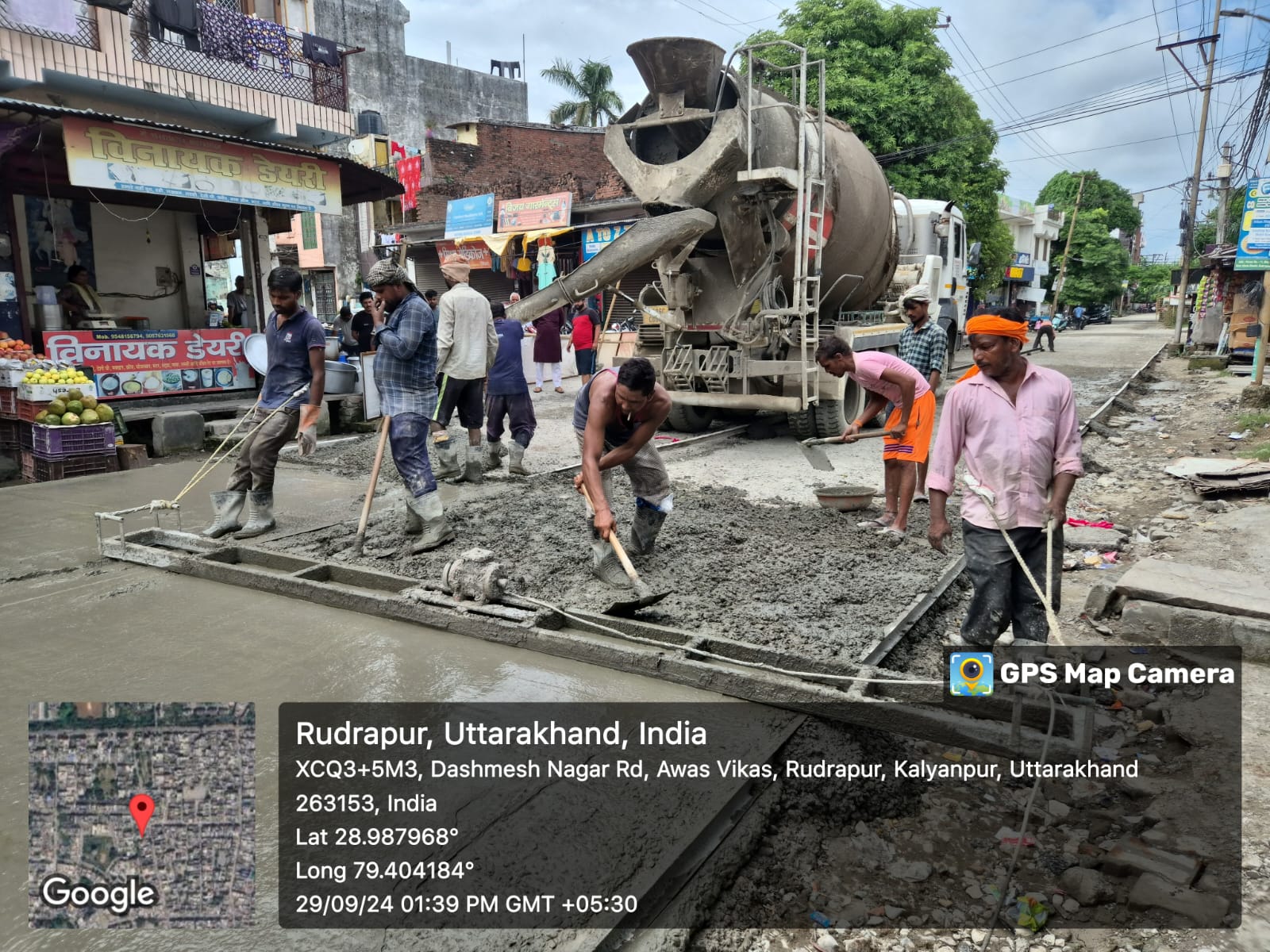

PQC Work In progress
on Sunday, September 29th 2024
PWD UttarakahndPhoto (ID 1159) from Site Received

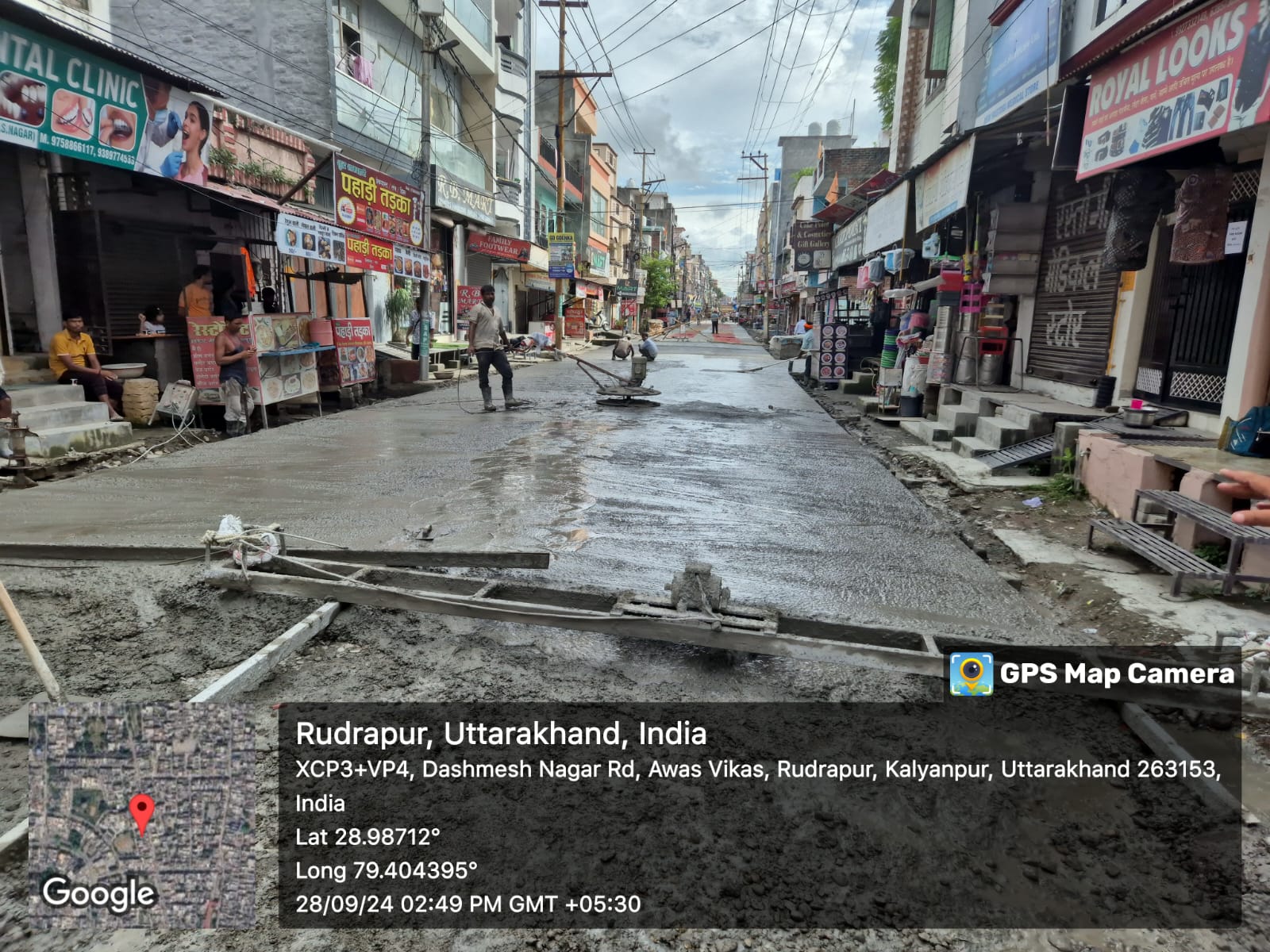

Work In Progress
on Sunday, September 29th 2024, 6:30:00 pm
61.34%
Financial Progress
8th Expenditure
of ₹ 3734868 (37.35 Lacs ) done.
Cummulative ₹ 99.35Lacs ( against 161.98Lacs )
on Tuesday, October 29th 2024, 6:30:00 pm
67.58%
Financial Progress
9th Expenditure
of ₹ 1011048 (10.11 Lacs ) done.
Cummulative ₹ 109.46Lacs ( against 161.98Lacs )
on Sunday, December 1st 2024, 6:30:00 pm
69.11%
Financial Progress
10th Expenditure
of ₹ 248524 (2.49 Lacs ) done.
Cummulative ₹ 111.95Lacs ( against 161.98Lacs )
on Thursday, December 19th 2024, 6:30:00 pm
71.16%
Financial Progress
11th Expenditure
of ₹ 331190 (3.31 Lacs ) done.
Cummulative ₹ 115.26Lacs ( against 161.98Lacs )
on Thursday, December 26th 2024, 6:30:00 pm
89.74%
Financial Progress
12th Expenditure
of ₹ 3010017 (30.10 Lacs ) done.
Cummulative ₹ 145.36Lacs ( against 161.98Lacs )
on Sunday, March 9th 2025, 6:30:00 pm
97.49%
Financial Progress
13th Expenditure
of ₹ 1256000 (12.56 Lacs ) done.
Cummulative ₹ 157.92Lacs ( against 161.98Lacs )
on Friday, April 4th 2025, 6:30:00 pm
100%
Physical Progress
Physical Progress Reported at 2nd time
